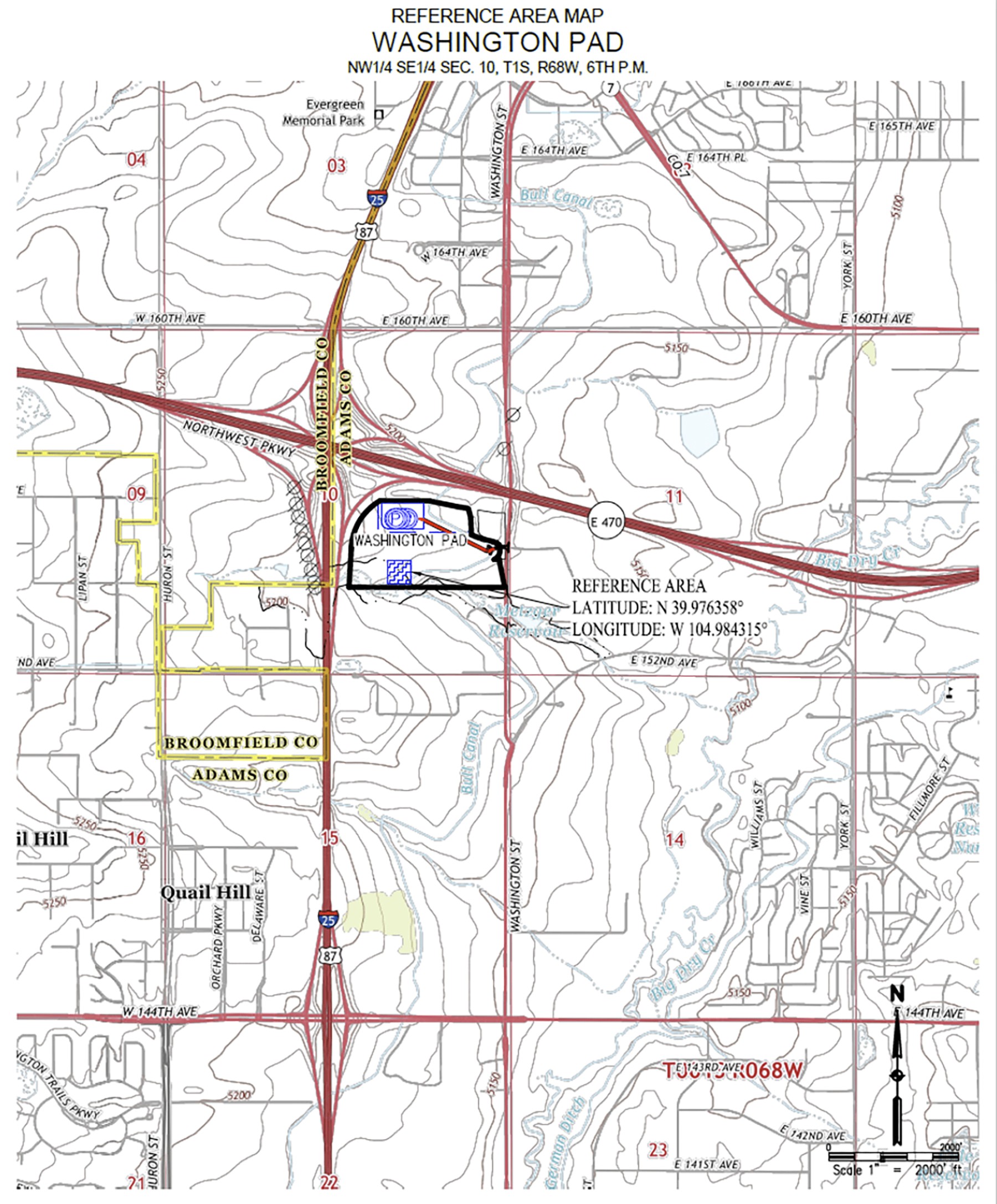

Washington Pad

Overview & Location

Extraction Oil & Gas is a wholly-owned subsidiary of Civitas Resources, Inc. Civitas was formed in November 2021 through the merger of four existing Colorado operators. Extraction’s oil and gas location, known as the Washington Pad, is located in the City of Thornton near the intersection of I-25 and E-470. A total of 10 wells will be developed from this pad, which will access around 1,600 mineral acres.

Location History

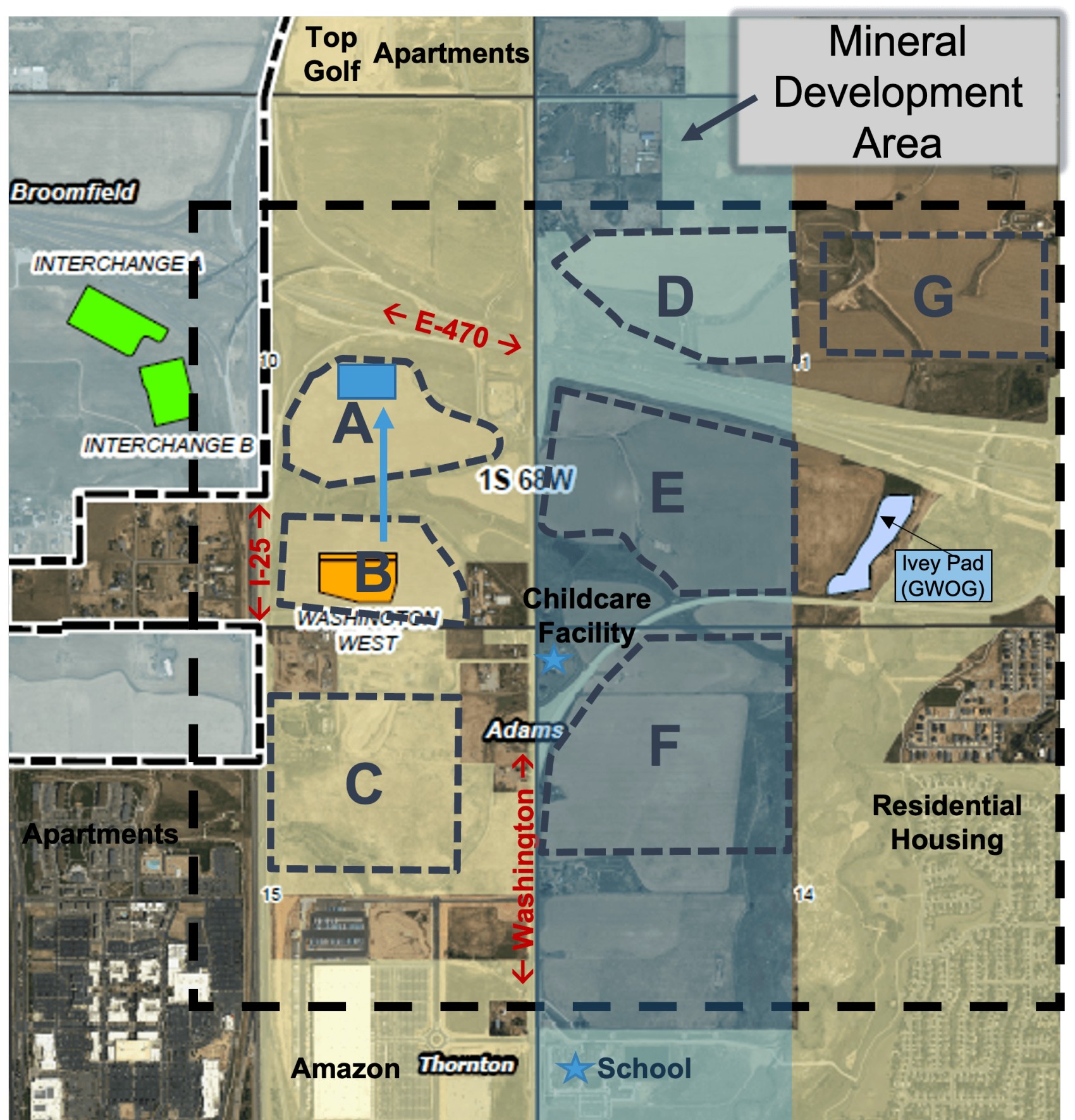

The site for the Washington Pad was selected to maximize the setback distances from residential housing and schools and to protect environmentally sensitive areas, while also ensuring proximity to existing oil and gas infrastructure and an efficient traffic routing plan. As part of the project, five legacy vertical wells will be eliminated and 4 miles of legacy gathering infrastructure will be retired.

Washington Pad Community Meeting

Current & Future Plans

Civitas expects that the permits will be approved during the summer of 2023. After the permits are approved, construction of the pad will begin and is expected to take roughly two months. Drilling is expected to begin in the fall of 2023 and will take an additional two months. When drilling is completed, crews will fracture the wells, another two month process that is expected to be completed by the end of 2023. Finally, the wells will be completed and prepped for production through the installation of tubing. After a short period of well cleanup,  production will begin around the second quarter of 2024. Safe and responsible operations are at the core of Civitas’s company values. Above all, our approach is defined by our commitment to working with our communities. In addition, legacy wells and infrastructure will be removed and decommissioned.

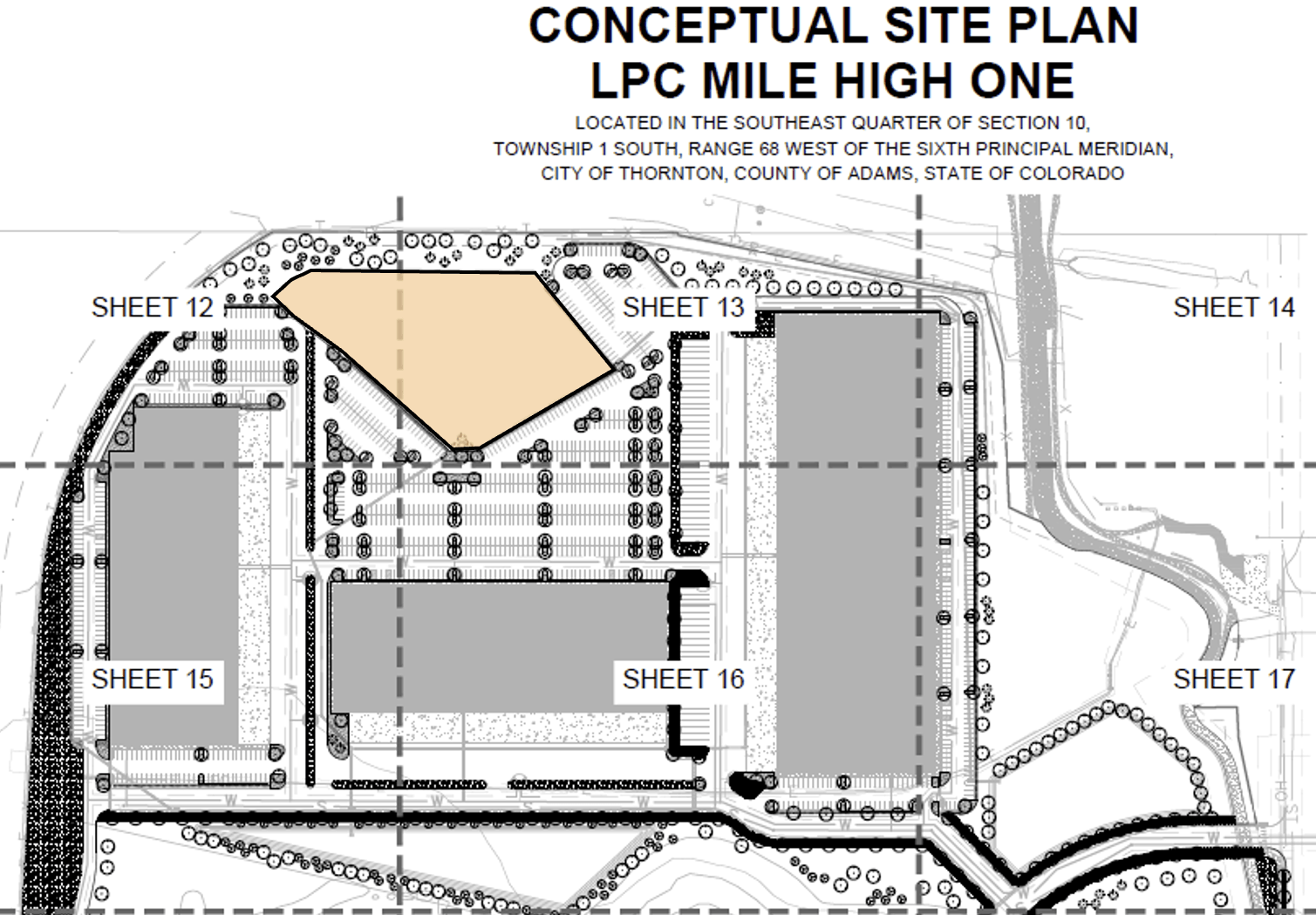

Conceptual Site Plans

Click to Expand

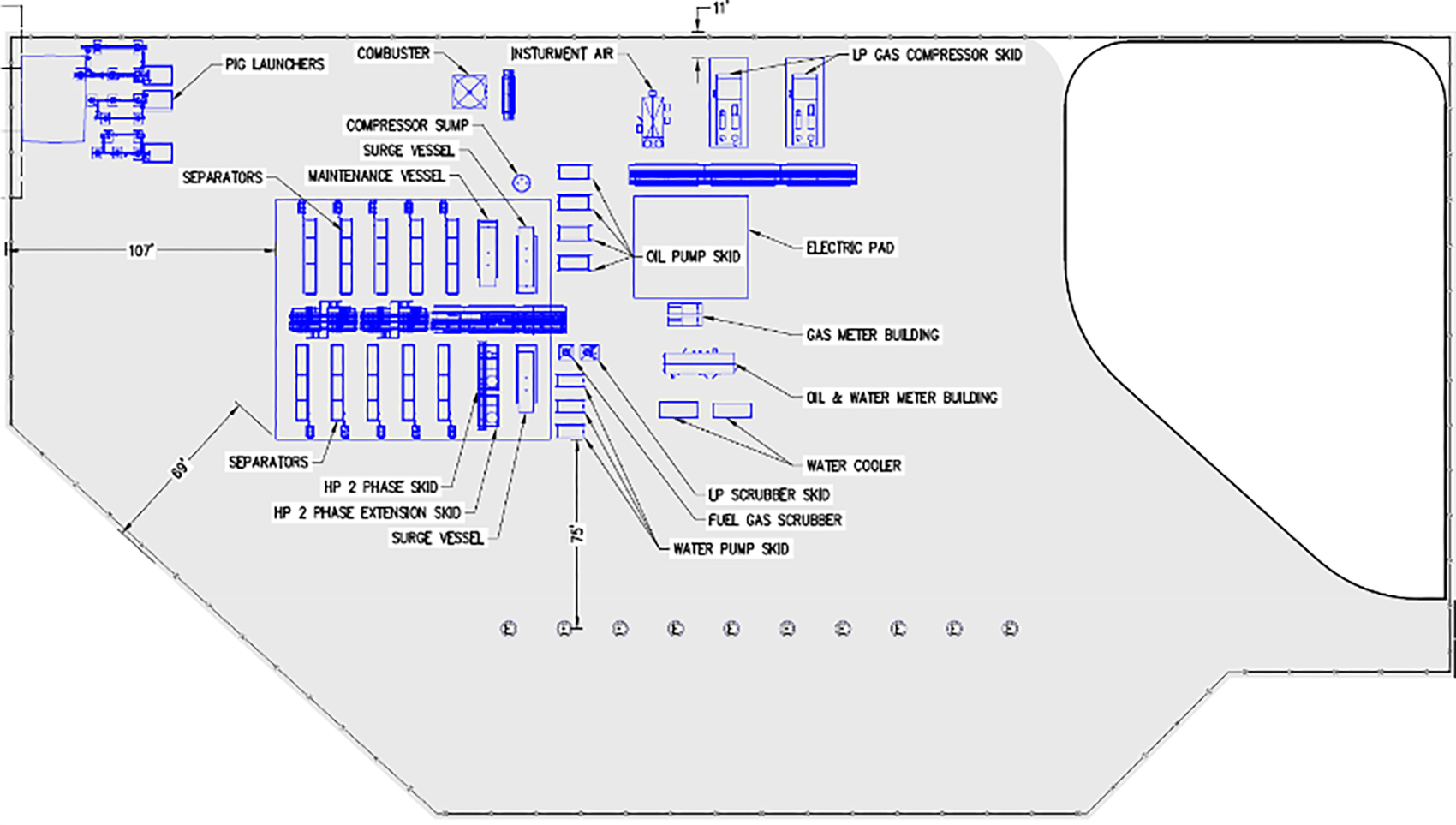

Facility Site Plan

Click to Expand

Legacy Removals

Click to Expand

New Well Sticks

Click to Expand

Anticipated Timeline

The following timeline intends to inform the sequence and timing of upcoming operations on the Washington Pad. We anticipate a six month cycle time from drilling to production.

Tab Dropdown
Pad Construction Spring/Summer 2024

Construction of the pad will begin in the spring/summer 2024. This process will include construction of sound walls to minimize disturbance to the surrounding area. The process of constructing the pad and the sound walls is expected to be completed by summer 2024.

Drilling Operations Summer 2026

Next we will begin the work to drill the wells. This process will take place in summer 2024. During this process, we will construct multiple layers of steel and cement casing around each well to ensure wellbore integrity. The drilling rig will be visible and you should expect to see our crews in the area, as well as downcast lighting and additional truck traffic.

Completions Operations Summer/ Fall 2024

Once drilling is complete, the rig will leave the site. We will spend the next thirty days completing each well and preparing to bring them online. This stage should be complete by summer/fall of 2024.

Initial Production Year End 2024

We expect to reach the production preparation stage in YE 2024. During this phase, all excess operational equipment will be removed from the site. Only the wellheads and associated facilities will remain. To ensure safety and environmental compliance, the wells will be monitored 24/7 through automated remote equipment.

Interim Pad Reclamation Year End 2024

Once the wells are producing, there will be little to no associated traffic on a day-to-day basis. the pad area will be reduced and the surrounding area will be reclaimed with native vegetation. The wells will continue to produce for up to 30 years. We expect to reach the production stage in YE 2024.

Note: The times provided are estimates and are subject to local authorization. We will keep you informed of any significant changes to our plans.

Best-in-Class Operations and Mitigation

Civitas leads the industry in innovative technological advancements, environmental stewardship and dedication to the communities where we live and operate. Some of our Best Management Practices (BMPs) for the Washington pad will include:

Erection of sound walls around the location prior to the commencement of drilling, to remain until the completions phase is completed.

Use of a downcast lighting plan to minimize disturbance.

Use of a closed-loop fluid management system to reduce emissions and odor.

Installation of a hard-surface apron and technology to suppress dust.

Use of a temporary lay-flat water pipeline to reduce truck traffic during pre-production.

Any Questions?

Please do not hesitate to contact us with questions about this proposed development. You can reach us via email at WashingtonPad@civiresources.com, by phone 720-279-9842 or by using the below contact form.

Please complete this required field
Please complete this required field
Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.
Please complete this required field
Please complete this required field
Please complete this required field

Civitas is committed to protecting and respecting your privacy, and we’ll only use your personal information to administer your account and to contact you with updates specific to our operations, as outlined on this page. If you consent to us contacting you for this purpose, please check the below box.

You can unsubscribe from these communications at any time.

By clicking submit below, you consent to allow Civitas to store and process the personal information submitted above to provide you the content requested.

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.
